PLM implementation
A predictable PLM project
Implementing a PLM is first and foremost a business project: your teams need to find their products, recipes, specifications and documents in the software, with their own rules, before they rely on it day to day.
beCPG is both the publisher and the integrator of its PLM. The consultants who run your workshops know the food and cosmetics industries, and the same team supports you after go-live.
Our method is designed to deliver value quickly, keep the scope under control and make your teams self-sufficient.
Agile, in phases
The project is split into phases. Each phase goes through scoping, functional workshops, configuration, delivery to your test environment and your sign-off: the equivalent of an agile sprint, anchored in a business scope.
We can also follow your own project methodology.

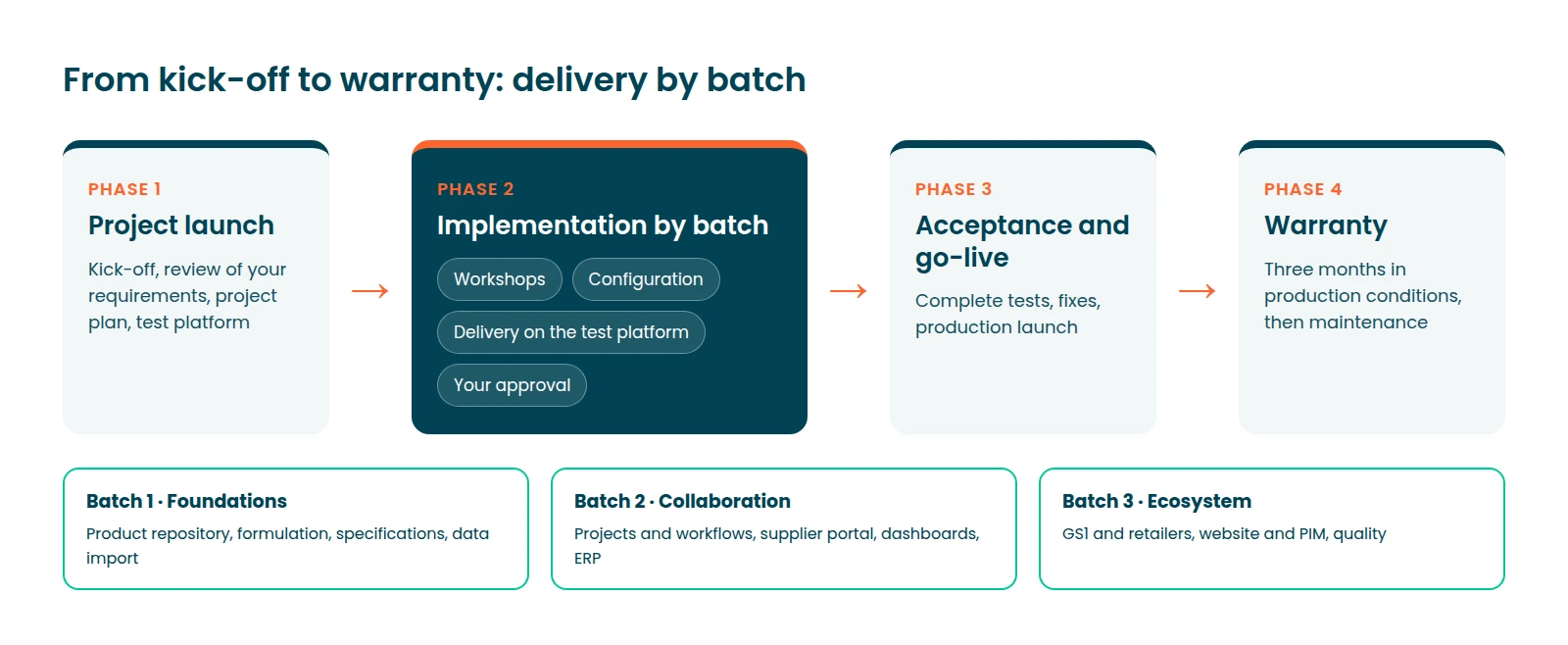

Plan your PLM project- 1
1. Project kick-off
Kick-off meeting, review of your requirements and of our proposal, discovery of your current tools and of the systems involved. Deliverables: a detailed project plan and a ready-to-use test platform.
- 2
2. Delivery in phases
Workshops, written specifications when the phase requires them, configuration and development with unit tests, delivery to the test platform. You sign off each phase before the next one builds on it.
- 3
3. Acceptance testing and go-live
Full functional testing on the test platform, fixes delivered and retested until acceptance is signed off, then go-live in production.
- 4
4. Warranty
Three months under production conditions after acceptance, with updated project documentation. Maintenance then takes over.
Workshops on your own products
From the very first workshop, we work on 3 to 5 of your reference products, with their raw materials, packaging and documents:
- Your key users create the products in beCPG with our consultants.
- Together, we check the calculations: nutritional values, ingredient list, allergens, origins, costs.
- We identify the configuration required and write up a workshop report.
- The configuration is delivered between two workshops and presented at the start of the next one.
- Your teams check the result on the same products.
Workshops take place on your premises, usually two to three days a month, with remote sessions in between, in French or English.

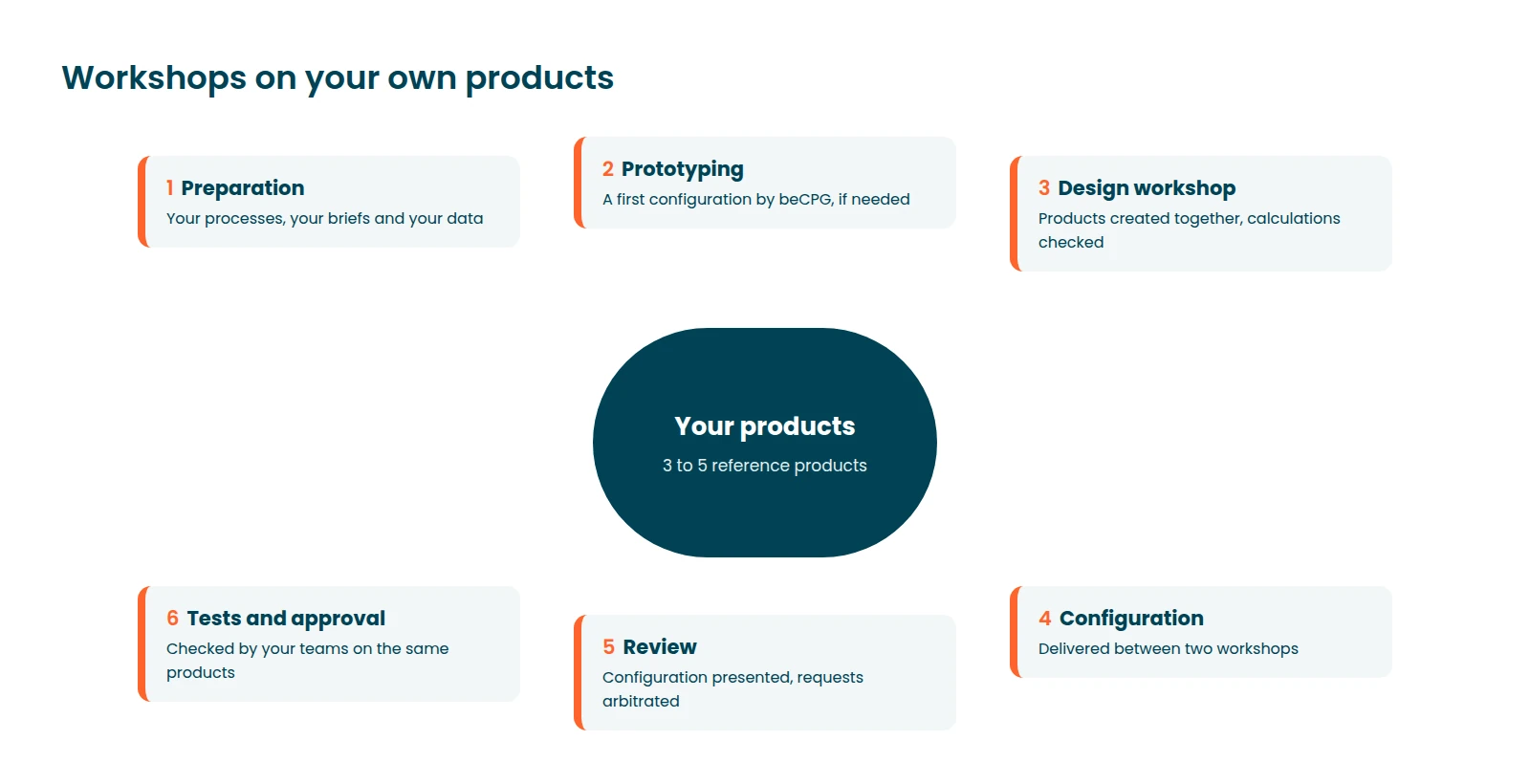

The workshop cycle
A typical scope
Depending on your priorities, a project usually follows this order:
A single configuration for the whole group
Built for multi-site groups
For a group, the effort depends on the number of processes and specifications to harmonize, not on the number of sites or products.

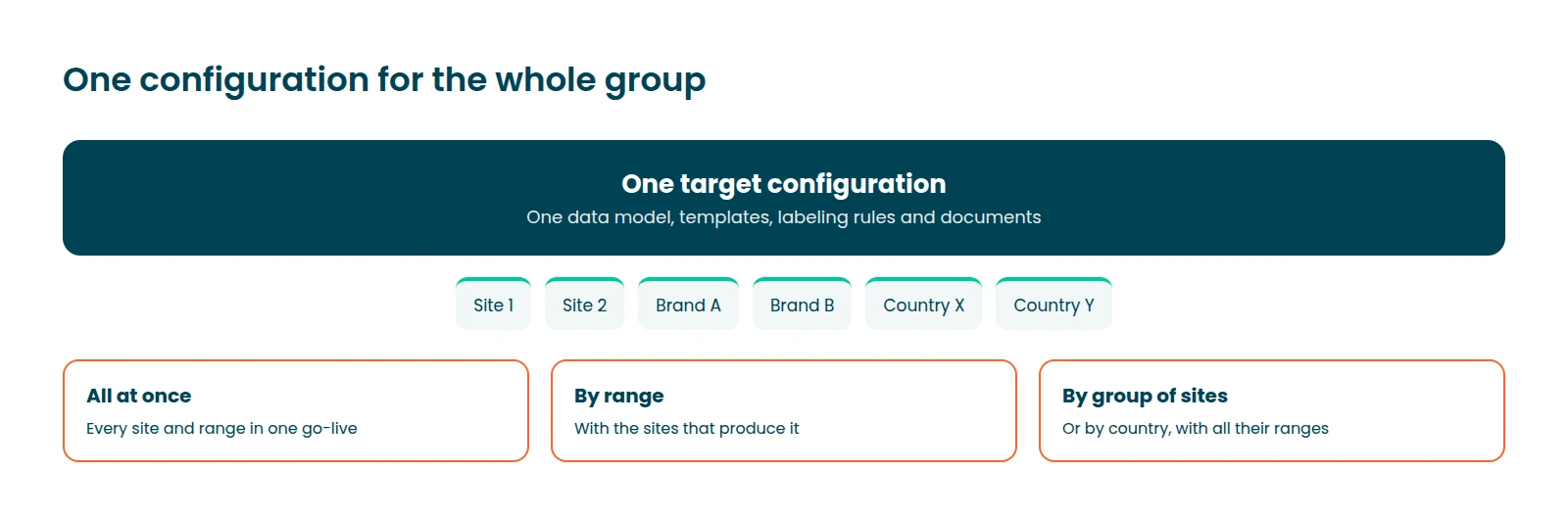

The target configuration is defined once and applies everywhere: a single data model, a single set of product templates, labeling rules and specifications. Each site, brand or country sees its own products, suppliers and documents through access rights, not through a configuration of its own.
Adding a site is a commissioning task (users, rights, data), not a new project. The roll-out can follow whichever pattern suits you:
- All sites and all ranges at once: the shortest path to a single source of truth.
- By range, with the sites that produce it.
- By group of sites or by country, with all their ranges.
Data can be loaded in a single migration or site by site, independently of the functional go-live. Bulk operations are designed for large portfolios: one of our customers manages 60,000 formulas and 30,000 raw materials in beCPG.
Governance and transparency
- Weekly project committee (30 minutes) to follow up on ongoing actions.
- Steering committee every 4 to 6 weeks: progress by feature, risks, next actions, change requests and decisions.
- A shared project portal: schedule, requests, issues, specifications and documentation are available to your team at any time.
- Roles defined before kick-off in a responsibility matrix: requirements, configuration, data import, testing, training and change management.
Key success factors
More than 15 years of PLM projects highlight the same factors, which we manage with you:
- A prioritized, precise and stable scope.
- The availability of your business and IT teams.
- Business teams that quickly become self-sufficient: around 90% of the configuration is accessible to your administrators.
- Data, business rules and processes structured before they are configured.
- Clear data ownership across departments.
- Change management.
- Planned data import and cleansing, with a designated owner.
An example project team
Each project has its own team, built around your scope. Here is an example, with the years of experience of each role in 2026.
Project management
- Project director11 years of experience, including 7 at beCPG
- Project manager and lead consultant12 years of experience, including 5 at beCPG
- PLM consultant2 years of PLM experience at beCPG
- Solution architect, co-founder21 years of experience, including 16 at beCPG · steering and architecture advice on demand
Technical and product team
- System administrator and DevOps7 years of experience, including 2.5 at beCPG
- Chief technical officer, co-founder21 years of experience, including 16 at beCPG
- Core product developer10 years of experience, including 5 at beCPG
- Reporting and document specialist7 years of experience, including 5 at beCPG
- Integration and API engineer9 years of experience, including 2.5 at beCPG
After go-live
- The consultants who implemented your project also provide its support, through a ticketing portal, by email and by video call, in French and English.
- One major release and three minor releases a year, delivered in the standard product: regulatory updates and new features benefit every customer.
- Three major versions maintained in parallel, giving you around three years to plan each upgrade.
- Training for users, administrators, system administrators and developers, as well as online documentation.
- Enhancements after go-live (new processes, reports or connectors) are handled as separate phases.
With your integrator
beCPG runs its projects directly, with no subcontracting. If you would like a local partner alongside us, we work with integrators such as CGI, T-Systems and Cronoplus, or with the integrator of your choice.
beCPG is open source: its code is accessible and your data can be exported at any time.
Our partnersThey have deployed beCPGSee all our customer references
How long does a PLM implementation take?
Most beCPG projects go live in 3 to 12 months, depending on the scope, the number of interfaces and the availability of your teams. A first phase (product repository, formulation, specifications) can be live within a few months, ahead of projects, the supplier portal and interfaces. For a small team starting with the standard configuration, setting up the SaaS environment takes about an hour of work (one command creates it, one file loads the initial data and another creates the user accounts), and it is usually ready a few days after your order.
Can we roll out site by site or country by country?
Yes. The configuration is built once for the whole group, then rolled out all at once, by range, by group of sites or by country. Data can be migrated in one go or site by site.
Who migrates our existing data?
beCPG provides the templates and import tools, then loads the data with you. Your teams are responsible for the content and its cleansing; the import plan is agreed at the start of the project.
Can we configure beCPG ourselves after go-live?
Yes. Around 90% of the configuration (lists, forms, reports, project templates, labeling rules) is accessible to your administrators, who are trained during the project.
Can we try beCPG before starting a project?
Yes. You can start a 30-day free trial or request a demo on your own products.
Plan your PLM project
Tell us about your products, sites and systems: we will propose a scope and a schedule.
